The SaaS product development process, or lifecycle, is a structured path from an initial business idea to a working cloud product. It covers product discovery, market validation, technical planning, UX/UI design, MVP development, testing, launch, and post-launch growth.
Each phase plays a role in achieving the exact goals you set, while reducing risks to a minimum. Discovery aligns the team on the vision. Validation tests whether the market needs the proposed solution. Technical planning ensures the optimal tech stack and architecture choice for your platform’s functionality and goals. Development turns the approved scope into working software. Testing and release ensure the product is ready for real users.
This guide explains the full SaaS product development lifecycle. It can be useful if you’re a founder planning a new SaaS product, a product leader replacing an outdated platform, or moving an existing solution to a subscription model. It is also relevant to teams that already have a product but need a clearer roadmap for scaling it.
For each stage of the SaaS development process, we’ll answer five practical questions:
Let’s start.

A SaaS product goes through eight stages on its way from an initial idea to a product customers pay for:
Research and validation → Product requirements & MVP scope → Technical planning → UX/UI design → Development → QA → Launch → Growth
The stages are shown in sequence, but in real life they often overlap, or a team returns to previous stages to revise made decisions. User testing may spot a need for changes in a workflow. Technical research may reduce the MVP scope. Post-launch data may move a new priority to the top of the roadmap. The process gives the team a way to absorb these changes without losing direction.
Let’s briefly look at what happens at each stage.
The team defines the business problem, target users, product goals, constraints, and initial scope. Then it checks whether the problem is significant enough that customers will pay to solve it.
Every product idea comes with assumptions. The team documents them and tests them through user interviews, competitor research, prototypes, landing-page tests, and early conversations with potential buyers. Some assumptions are confirmed, some remain open, and some are disproved. This stage is the least expensive point to find that out.
The result is a shared understanding of what the product should do and for whom.
From there, a team can start mapping out functionality and define what should go in the first version of the product. This means a release scope, a prioritized backlog, mapped dependencies, feature requirements, and acceptance criteria for each item.
Technical planning turns product requirements into a technical foundation. The team decides how the platform will handle multitenancy, data structure, cloud infrastructure, security, integrations, deployment, and scaling.
The architecture should match the current product needs, cost, and nearest growth plans. Too little planning leads to costly rework once real customers and real data arrive. Too much planning spends the first release’s budget on scale the product may never need.
Design translates requirements and user journeys into wireframes, prototypes, and a complete UI kit. A clickable prototype lets the team test workflows with users while changes are still quick and inexpensive.
Good SaaS design reduces friction in tasks people repeat every day. It also covers roles, permissions, onboarding, error states, and administrative workflows.
Development turns approved designs, requirements, and architecture decisions into working software. The team works in short 2-or 4-week iterations, and each one ends with a demo of functionality stakeholders can review.
Working in short iterations (sprints) lets the team stay flexible and squeeze in changes with minimal impact on the budget and timeline. New requests go into the backlog first, but your team can consider adding them in the next sprint if they are valuable for the current release. If so, the development team shows the impact on the timeline and budget, and the product owner decides how to proceed.
QA confirms that the product works as intended and meets the agreed release criteria. Testing covers functionality, integrations, security, performance, usability, and compatibility.
QA runs from the first sprint, and this approach makes fixes much easier and cheaper. A defect found during development is usually quick to fix. The same defect found shortly before launch may require changes across several connected features.
Launch is when your product goes into production. This stage covers deployment, monitoring, analytics setup, data migration where needed, support processes, and release communication.
Completed features are only part of launch readiness. The team also needs to perform final testing, prepare rollback plans, and be ready to address any issues that might appear right after launch.
After launch, product analytics, customer feedback, support data, and revenue results guide your roadmap.
The team expands workflows that prove useful, reduces technical debt, optimizes infrastructure costs, and scales the system as demand grows. At this stage, the MVP develops into a sustainable SaaS product.
Each stage ends with reviewable deliverables and a decision: move forward, revise the current work, or pause until a critical assumption is resolved. Product development always carries some uncertainty, and this approach keeps it visible and manageable.
Many failed SaaS projects can trace the problem back to the weeks before the first sprint. The team starts development before it has clarified the problem, target users, scope, business model, and success criteria. From that point, even a capable development team can move quickly in the wrong direction.
The early stages have the greatest influence on budget, timeline, and product viability. Decisions made before the first sprint determine what the team creates, how the system is designed, and which assumptions remain untested. Uncertainty that goes unresolved at this point usually comes back as rework during design, development, or launch.
One of the most common mistakes is treating an idea as a validated product concept. A founder may understand the industry and recognize a real problem. That still doesn’t confirm that the proposed SaaS product solves the problem in the right way. The target users may already rely on a workaround, value a different feature, or be unwilling to change their current process.
Another common mistake is defining the scope as a long list of desired features. A feature list doesn’t explain which user problem each feature solves and how the product makes revenue. Without these answers, every feature looks equally important. The MVP grows too large, estimates lose accuracy, and the team spends time on functionality that doesn’t help validate the product.
Teams sometimes also choose technologies too early, before product requirements are clear. This reverses the correct order of decisions: technology should be chosen based on the product’s workflows, security needs, integrations, and expected scale.
Other early mistakes include:
These issues create false progress. The team completes sprints and releases features while the product moves further away from product-market fit.
Development speed matters only after the team knows what it should create.
Early preparation turns an initial idea into a set of testable product decisions. You get a clear view of the target user, core problem, expected business outcome, main workflows, constraints, and the assumptions that still need evidence.
Uncertainty never disappears completely in SaaS product development, but preparation significantly reduces it.
For example, a prototype can show that users don’t understand a key workflow before the frontend is developed.
Technical research can expose integration limits before the architecture depends on an external API.
Market validation can show that a planned feature has no effect on buying decisions.
Each of these findings is easy to act on early. After several development sprints, the same finding can mean reworking finished features.
An experienced SaaS team starts by asking what the product must prove, and only then looks at the requested feature list. It connects business goals, user needs, and technical decisions, and sets clear approval points:

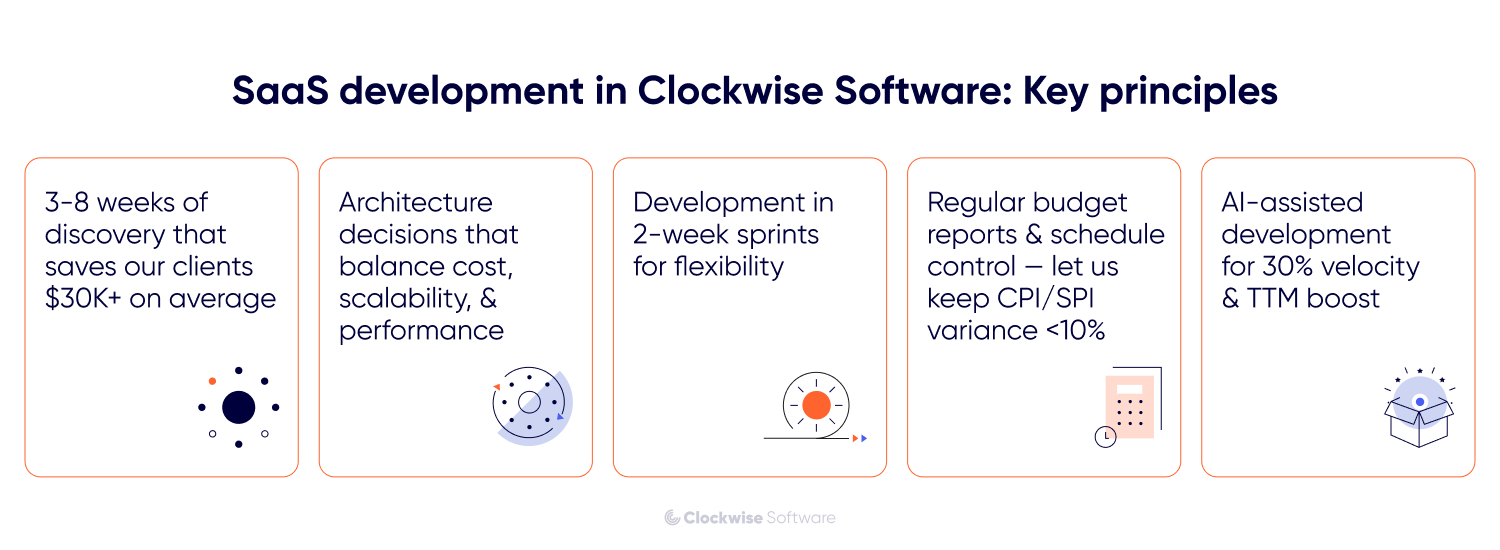

We’ve been working on SaaS products since 2014, and have experienced how a structured early process helped our team find details, dependencies, and constraints that would cause massive delays if discovered mid-project
In practice, this preparation happens during product discovery. Discovery usually combines the first 4 phases of the SaaS development process we’ve mentioned earlier, and each one answers its own question:
This guide describes these phases separately because each produces its own deliverables. Together, they give the team a validated problem, an approved MVP scope, an architecture plan, and tested designs – basically, everything needed for development.
This phase turns an initial SaaS idea into a product concept the team can evaluate and plan. It connects the business goal with a specific customer problem and defines what the first release must prove.
The goal is to reduce uncertainty before the company commits a larger budget to design and development, so future features can wait for later phases. By the end of research and planning, the team should understand the target market, core users, product value, initial scope, major risks, and the likely range of investment.
Research starts with the business case. A SaaS product cannot be planned around features alone. The team must understand why the company is creating the product and which result would justify continued investment.
The business goal may be to launch a new revenue stream, automate an internal process, replace a legacy product, enter a new market, or improve an existing platform. Each goal creates different product and technical priorities.
The team should define:
These decisions create a basis for product scope. For example, a product designed to validate market demand needs a focused MVP and strong product analytics. A platform replacing an existing system may need migration, operational continuity, and integration planning from the start.
The business goal should be specific enough to guide trade-offs. “Build a modern SaaS platform” is too vague to act on. “Allow small logistics companies to automate route planning without enterprise software” gives the team a clear problem, audience, and direction.
Market validation tests whether the identified problem is significant enough to support a product. Competitor analysis shows how the market currently addresses that problem. Together, they answer two questions: is there real demand, and does the proposed solution offer a meaningful alternative to existing tools, internal processes, or manual work?
On the customer side, the team should investigate:
On the competitor side, the comparison should go beyond feature lists and cover:
Read market size and competition carefully. A large industry may still be difficult to enter if buyers have low urgency, high switching costs, or established vendor relationships. A crowded market often confirms demand, but the product then needs a defensible reason for customers to switch.
The output should show which assumptions have evidence, which remain uncertain, and which have been disproved. If the core problem cannot be confirmed, the team should revise the concept before moving deeper into SaaS product development.
User interviews provide context that analytics and market reports often miss. They help the product team understand real workflows, decisions, workarounds, and frustrations.
Interviews should focus on past behavior. Hypothetical questions like “Would you use this product?” often produce weak evidence. A more useful discussion explores how the person handled the problem recently, which tools were involved, where delays occurred, and what consequences followed.
Useful questions include:
The team should look for repeated patterns across interviews. One unusual request should not define the roadmap. Consistent problems, common workarounds, and repeated buying criteria provide stronger evidence for the first product scope.
Interview findings should connect directly to user flows, product requirements, and feature priorities. Otherwise, research becomes a separate activity that does not influence development.
Research shows which problem the product should solve and for whom. This phase turns those findings into a concrete plan for the first release: which functions the product needs, which come first, and how each one should behave.
The result is a shared definition of the MVP for designers, architects, developers, and QA. It also makes the first reliable estimate possible.
The work starts with the user workflows identified during research. For each core workflow, the team lists the functions a user needs to complete it from start to finish. Onboarding, for example, may require account creation, email verification, team invitations, and workspace setup.
The list should also cover functionality users rarely see but the product can’t run without: authentication, roles and permissions, billing, notifications, administration, and product analytics.
The full list is usually too long for one release, so prioritization decides what goes first. Every proposed function should connect to a user problem, business goal, or validation need. A useful priority model separates features into:
Product leaders should resist prioritizing features only because competitors have them. A competitor may serve a different market, pricing tier, or customer workflow.
Prioritized features then become the scope of the first release. A focused MVP may support one customer segment, one main workflow, and a limited number of integrations. This is acceptable if the release can deliver value and test the main product assumptions.
Here’s how this works on one of our projects. BackupLABS is a B2B SaaS platform that backs up data from services like GitHub, GitLab, and Trello. At the start, integrations were prioritized one by one. GitHub came first because it was the client’s top priority and gave the team a reusable base for the integrations that followed. We kept the rest of the scope just as focused: billing, for example, launched with a single Essential plan through Stripe. More integrations, advanced payment plans, and other features were scheduled for later releases. This way, our client launched the product sooner and started validating its value with UK customers.
The MVP should also include enough operational functionality to be used safely. Authentication, backups, monitoring, error handling, and support processes rarely attract customers, but they still belong in any SaaS product.
The first release should usually leave out features that add complexity without helping validate the main product value. Common examples include:
AI is worth highlighting here: it can support a SaaS product when it improves a specific user decision or task. Adding it only for marketing value usually backfires: AI features introduce their own costs, quality risks, data requirements, monitoring needs, and fallback scenarios.
Each feature in the approved scope needs written requirements before design and development begin. Requirements give designers, developers, and QA engineers one shared definition of how the feature should work.
A good feature requirement describes:
The format can be user stories, use cases, or a specification document. Pick whichever the team will keep up to date: specification documents and use cases are usually used for more enterprise software or other complex products; user stories are a great choice for almost any SaaS.
Requirements should be detailed enough to estimate and test. Plus, each requirement needs acceptance criteria: the conditions that must be true for the feature to be approved. Good criteria are specific and testable. They describe expected behavior, business rules, permissions, error conditions, and measurable results.
For example, “Users can invite teammates” is incomplete. The criteria should clarify:
Clear acceptance criteria improve estimates, development, QA, and stakeholder reviews. They also reduce arguments about whether a feature is finished.
At the release level, the team should define broader criteria for security, performance, analytics, documentation, infrastructure, and support readiness.

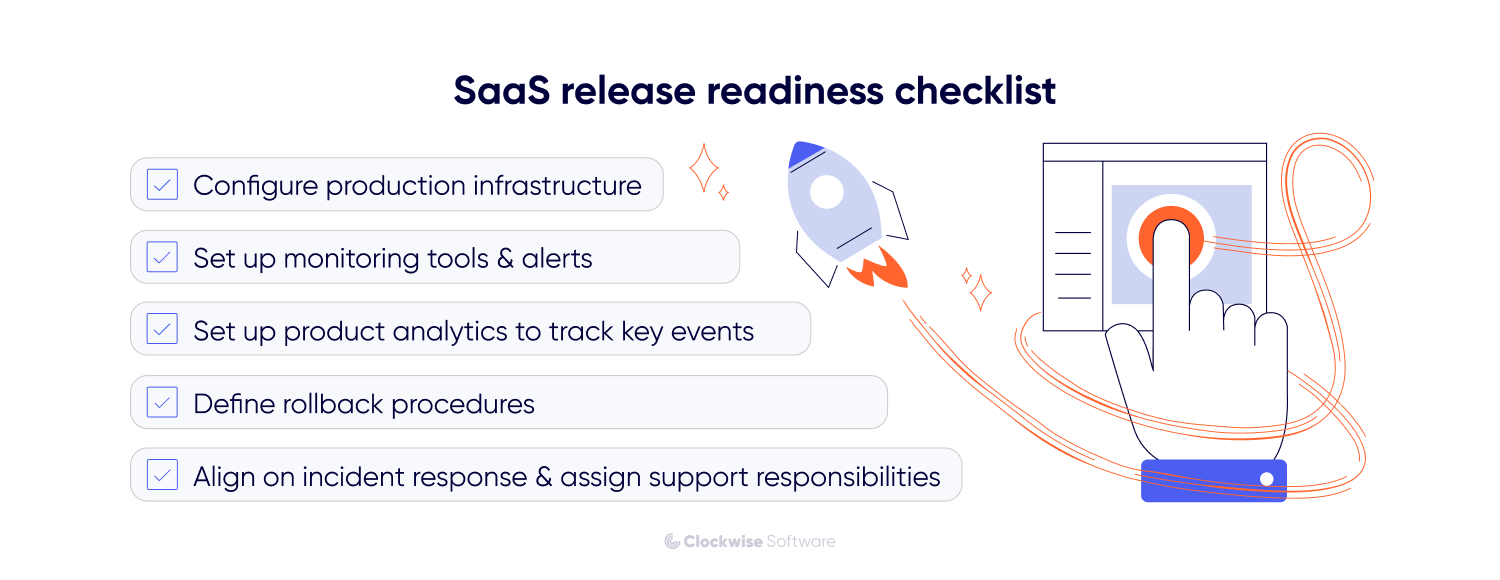

This phase should produce:
The final MVP backlog should be small enough to deliver within a controlled budget and complete enough to create value for early users.
With requirements and MVP scope approved, the team can plan the technical foundation: tech stack and architectural design. Product architecture defines how the SaaS platform will support its users, data, business rules, integrations, security requirements, and expected growth.
The goal is a technical foundation that fits the current product and leaves a reasonable path for expansion. Weak SaaS architecture can make every later feature slower, riskier, and more expensive to deliver.
Architecture decisions should follow the product requirements defined in Phase 2. The team needs to understand the main workflows, expected usage, tenant model, data sensitivity, integrations, availability requirements, and likely areas of change.
A small MVP may work well as a modular monolith. Compared with a distributed microservices system, this approach is usually faster to develop and test. Microservices may become useful when the product requires independent scaling, separate deployment cycles, or clearer boundaries between complex domains.
The correct choice depends on the problem. Architecture should not be selected because a pattern is fashionable or because the team used it on a previous project.
The team should document major decisions and their trade-offs: why an approach was selected, which alternatives were considered, and what conditions may require the decision to be reviewed.
Multi-tenancy allows one SaaS platform to serve multiple customers while keeping their data and configuration properly separated.
The team must decide which resources are shared and which are isolated. Common approaches include:
A shared model can reduce operating costs and simplify updates. Greater isolation can improve control, customization, or compliance, and it also increases infrastructure and maintenance costs.
The decision should consider:
Tenant isolation must be enforced throughout the system. A tenant ID in a database table is insufficient if authorization, caching, logging, file storage, or background tasks can still expose information across accounts.
Security should shape SaaS architecture before development begins. Controls added late often require changes to permissions, data flows, infrastructure, and application logic.
The architecture plan should address:
Pay attention to the fact that compliance and security are separate concerns. A product may satisfy a compliance checklist and still contain technical weaknesses. Security needs continuous review, testing, monitoring, and a clear owner.
Scalability means the product can support growing demand without performance loss, instability, or cost.
Planning for scalability starts with realistic assumptions. The team should estimate expected tenant numbers, user activity, transaction volume, storage growth, integration load, and traffic patterns.
Few products need infrastructure for millions of users at launch. Premature scaling increases cost and slows development. At the same time, the architecture should avoid decisions that make normal growth difficult.
It’s important to find a balance here. Here are some questions that can help:
A scalable SaaS architecture should support measured growth. Monitoring after launch provides the evidence for further optimization.
The technology stack should support product requirements, team capability, security, maintainability, and hiring.
A common stack makes hiring and support easier. A specialized technology may be justified when it solves a specific product constraint, and the reason should be clear and documented.
The stack should also support a clean handover. Obscure tools that only one developer understands create a dependency risk, so they need a strong, documented justification.
Technical planning should give the development team enough detail to start work with a clear picture of core system behavior.
Typical deliverables include:
The architecture should stay understandable to both technical and product stakeholders. Business leaders can skip implementation-level detail. They should still understand how major decisions affect cost, security, delivery, and future growth.
UX/UI design turns the approved requirements and MVP scope into an interface users can understand and operate. Good SaaS design reduces friction in the tasks people repeat every day. It also covers the parts of the product that rarely appear in a pitch: roles, permissions, onboarding, empty states, error handling, and administration.
User flows describe how a person moves through the product to complete a specific task. They connect product requirements with interface design and development.
Each flow should account for roles, permissions, decisions, error states, and dependencies. The ideal path covers only part of real usage. Real users forget passwords, enter incomplete data, lose connections, lack permissions, and abandon tasks halfway.
Mapping these scenarios early exposes missing requirements before the team starts designing screens.
Wireframes define the structure of each screen: what information appears, in what order, and which actions are available. Low-fidelity wireframes leave out visual styling, so the team can focus on layout and logic.
Information architecture sets how the product is organized as a whole. It defines the navigation, how features are grouped, where users find settings, and which areas each role can see. An administrator and a regular user may use the same product and still need very different navigation.
Wireframes are fast to change. This is the least expensive point to rearrange a workflow, merge screens, or remove unnecessary steps.
A clickable prototype connects wireframes or early designs into working flows. Users can click through a task as if the product already existed.
Testing the prototype with representative users shows whether the core workflows make sense to the people who will use them. Five to eight sessions usually reveal the main usability problems.
During testing, the team should observe:
Findings go back into the flows and wireframes. Sometimes they also change the requirements from Phase 2. For example, a test may show that a planned step is unnecessary or that a missing option blocks the main workflow.
UI design applies the visual layer to the low-fidelity wireframes: brand, typography, color, spacing, and iconography. For a SaaS product, this work should produce a design system along with the screens.
A design system includes:
A design system keeps the interface consistent, speeds up frontend development, and lets the team add new features later without redesigning existing screens.
Accessibility belongs in this stage too. Sufficient color contrast, keyboard navigation, readable text sizes, and clear focus states make the product usable for more people. Enterprise and public-sector buyers often require conformance with WCAG 2.1 AA.
Designs should also cover every device and screen size included in the MVP scope.
Developers need more than final screens. A complete handoff includes:
Designers should stay involved during development. They answer questions, review the implemented interface, and adjust designs when technical constraints appear.
Development turns the outputs of discovery into working software: the requirements and acceptance criteria from Phase 2, the architecture from Phase 3, and the approved designs from Phase 4. This is where the SaaS product becomes usable.
A professional SaaS development process combines engineering, testing, product reviews, documentation, and continuous risk control. Each development cycle should produce a working result that stakeholders can review. This gives the product owner regular opportunities to correct priorities before problems spread across the system.
The goal is to deliver the first production version within the approved MVP scope. New ideas will keep appearing, and they go into a controlled backlog so active development can continue without interruption.

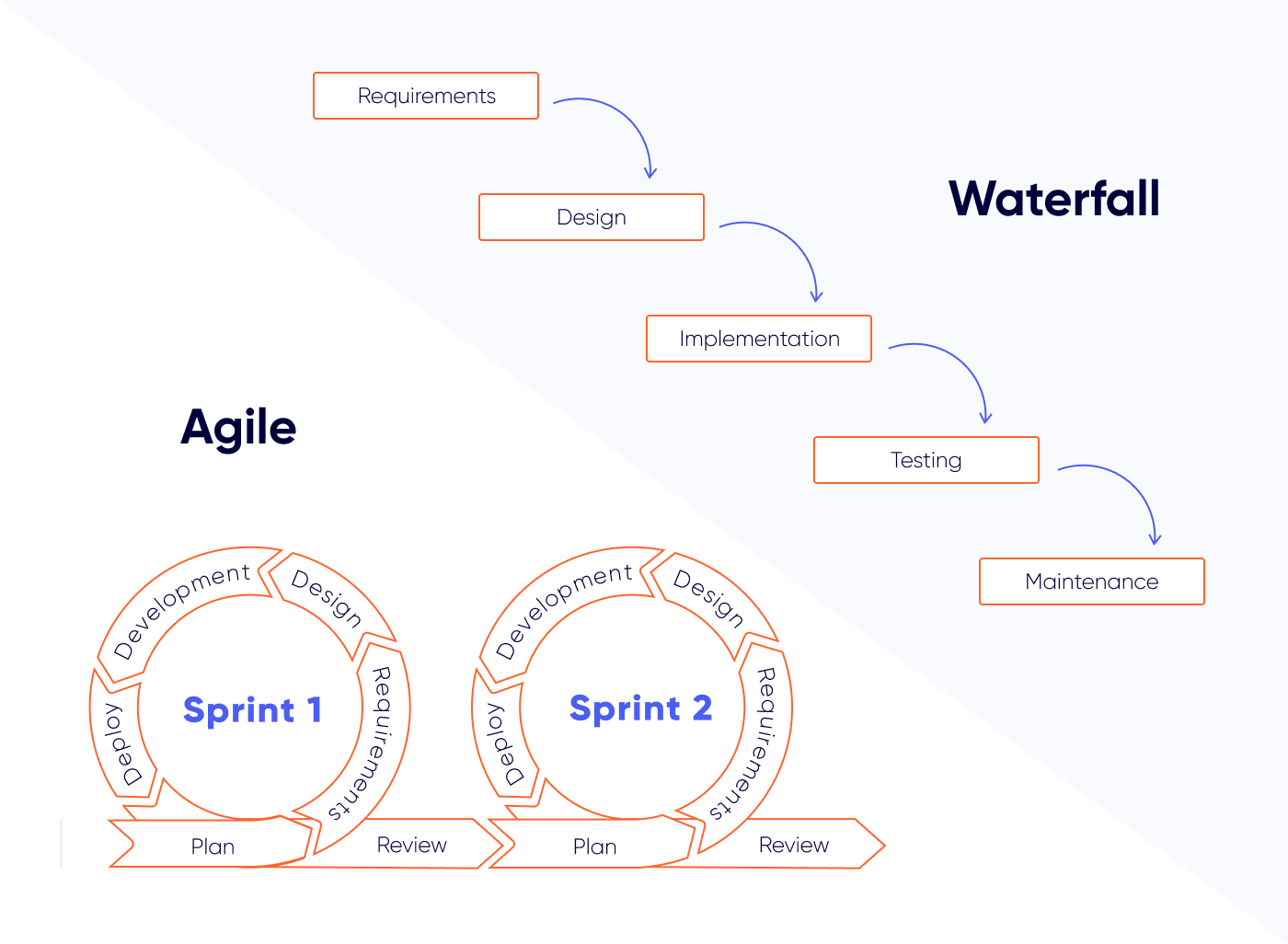

Development is usually divided into short 2- or 4-week iterations, or sprints. Before each sprint, the team selects a realistic set of backlog items based on priority, dependencies, and available capacity.
A sprint should have a clear objective. The team should aim to complete a meaningful part of a user journey and avoid grouping unrelated tasks. For example, one sprint may cover account creation and onboarding. Another may deliver the first version of the product’s core workflow.
During sprint planning, the team reviews:
Sprint planning also protects the team from uncontrolled scope changes. Urgent requests can still appear, but their effect on existing commitments must be visible. If new work enters the sprint, other work may need to move.
At Clockwise Software, sprint planning sessions and product demos keep the client involved without daily micromanagement. The client sees working functionality, reviews progress, and can adjust priorities based on actual results.
The backend manages business logic, data, permissions, integrations, and communication between system components. It must support the user experience while enforcing rules that cannot depend on the interface alone.
In a multi-tenant SaaS product, every backend operation must respect tenant boundaries. The system should verify both the user’s identity and their right to access a specific resource.
Developers also need to handle failures. External services may be unavailable. Payments may fail. Background jobs may run twice. Users may submit incomplete or conflicting data. Production-ready backend logic should manage these conditions without corrupting information or exposing another customer’s data.
The team should keep business rules separate from infrastructure and interface code where practical. Clear module boundaries make the product easier to test, extend, and maintain as the roadmap grows.
The frontend turns the approved UX/UI designs into an interface users can operate across supported browsers and devices.
Frontend development goes well beyond recreating static screens. Developers must implement navigation, state changes, form behavior, permissions, loading states, validation, errors, and accessibility.
The frontend should use the components and rules from the design system created in Phase 4. This keeps the interface consistent and reduces the effort needed to add new workflows later.
Close cooperation between designers, developers, and QA engineers is important. A screen may match the visual design and still create a poor experience if validation, errors, permissions, and edge cases were overlooked.
Most SaaS products depend on external systems. Common integrations include payment providers, CRMs, analytics platforms, communication tools, identity providers, accounting systems, mapping services, and industry-specific software.
The SaaS application should never assume that an external service always responds correctly. Integration logic needs timeouts, logs, retries where appropriate, and a way to recover from partial failures.
The team should also define what happens if a provider changes its API, increases prices, or becomes unavailable. Critical workflows may need a fallback or an abstraction layer that reduces dependence on one vendor.
Integration testing should use realistic scenarios. A successful test request does not prove that the full workflow will stay reliable in production.
AI features can improve search, classification, recommendations, content generation, forecasting, support, and workflow automation. But each one should be added only if it solves a defined product problem. Before adding AI to a SaaS product, clarify:
AI output is probabilistic. The same input may produce different results, and a convincing response may still be incorrect. Product design must account for this behavior.
High-risk decisions should not rely on unverified model output. The system may need confidence thresholds, source references, human approval, or deterministic validation rules.
Engineering standards help the team release changes without making the product harder to maintain.
Here are the core practices:
A development team should also make technical debt visible. Some shortcuts may be reasonable during MVP development, and the team should document them and understand their impact. Hidden debt becomes harder to prioritize and more expensive to address.
The development phase should produce more than completed tickets.
Expected deliverables include:
The client should have access to the source-code repositories, backlog, working environments, and delivery reports. This preserves control and makes progress verifiable.
Quality assurance confirms that the SaaS product works as expected, protects customer data, and is ready for real usage.
QA starts well before development ends. QA engineers should review requirements and acceptance criteria from Phase 2 before implementation begins. At that point, they can spot missing scenarios or potential risks while changes are still inexpensive.

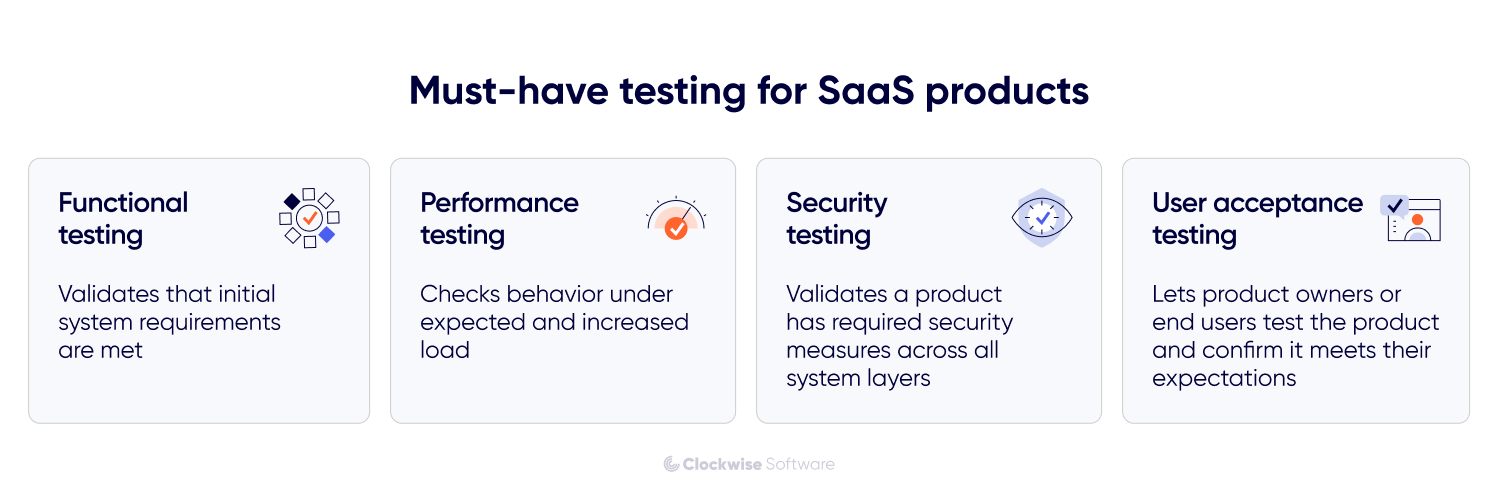

The SaaS testing process frequently combines manual and automated checks. Automation protects stable workflows from regression. Manual testing helps evaluate new behavior, usability, and unexpected interactions. In relatively small projects, it may rely only on manual testing—for such products, automation may add costs without adding value or speed.

Functional testing verifies that features follow approved requirements and business rules.
The QA team checks complete user journeys from start to finish, along with individual screens. This covers authentication, onboarding, permissions, core workflows, billing, notifications, integrations, and administration.
Role and tenant combinations require particular attention here. A function may work correctly for an administrator but expose information to a standard user or another customer.
Performance testing shows how the application behaves under expected and elevated load.
The team may test:
The objective is to find likely bottlenecks and establish a performance baseline before launch. Test loads should reflect realistic usage forecasts.
Results should be linked to agreed requirements. “The platform feels fast” is not a release criterion. Key operations need measurable targets, such as response times for the core workflow, and monitoring after deployment.
Security testing checks whether the product protects accounts, data, infrastructure, and tenant boundaries.
It may include:
The depth of security testing should match the product’s risk profile. A healthcare or financial platform needs extensive controls and often external penetration testing. A low-risk internal tool may need a lighter set of checks.
Critical issues must be resolved before launch. Lower-risk findings should have an owner, priority, and remediation plan.
User acceptance testing is usually performed by someone on the client’s side: a product owner, client representatives, or selected users. They test the product against agreed scenarios, and confirm whether workflows match the intended process, solve the expected problem, and take into account all operational requirements.
Feedback should be classified carefully. A defect, a missing approved requirement, and a new feature request are different types of work. Treating every UAT comment as a bug creates uncontrolled scope growth.
Deployment may seem quick, but it involves much more than clicking a launch button. The team prepares infrastructure, monitoring, analytics, support, incident response, and recovery procedures. A controlled launch reduces operational risk and shows how the product performs outside the test environment.
The team should decide how the product reaches users. The most common options are:
For most new SaaS products, a beta or staged rollout is the safer starting point. Early users surface real-world issues while the support load stays manageable.
The production environment should be configured separately from development and staging, and access should follow the principle of least privilege.
Launch preparation covers cloud resources, production databases, domains and certificates, data storage, backups, email and notification services, payment configuration, logging, and deployment pipelines. Where possible, all of this should be reproducible. Infrastructure-as-code and automated deployment reduce manual configuration errors and make recovery easier.
The team should also confirm that production capacity matches expected initial demand, and know which resources can be scaled quickly if usage exceeds forecasts.
Monitoring helps the team detect issues before they affect a large number of users. At a minimum, the product should track application and API errors, response times, infrastructure and database performance, failed background jobs, integration and payment failures, authentication problems, and the health of critical user journeys.
Alerts should point to conditions that require action. Too many low-value alerts create noise and make real incidents easier to miss. Every critical alert needs an owner and an escalation path: who responds, how the issue is investigated, and when stakeholders or customers are informed.
Product analytics show whether users reach the value the product was designed to provide.
Before launch, the team should define events and metrics tied to the product’s main assumptions. Typical examples are onboarding completion, first use of the core feature, time to first value, trial conversion, retention, and churn. Tracking should be tested before release, since missing or inconsistent events make early product data unreliable.
A small set of metrics that explain activation, engagement, conversion, and retention is enough to start. Every tracked event should connect to one of them.
Every production release carries risk. A rollback plan defines how the team will restore a stable version if a critical issue appears.
The plan should name the conditions that trigger a rollback and the person authorized to make the call. It should also explain how the team handles previous application versions, configuration changes, feature flags, data created during the failed release, and customer communication.
Database changes require particular care. Application code is usually easy to restore, while an incompatible migration can make rollback difficult. The team should test the full deployment and recovery process before the public launch, because a procedure that exists only in documentation may fail when time is limited.
Users need a clear way to report issues after launch, and the team needs a process for classifying and responding to those reports. The support plan should define channels, working hours, severity levels, response expectations, escalation rules, and engineering ownership.
Many user questions can be resolved without developer involvement. Support staff should have product documentation and a clear route for escalating technical issues. Critical incidents should be reviewed after resolution to understand what happened, why existing controls missed it, and which changes will reduce the chance of recurrence.
A SaaS product is ready to launch when the team can deploy it, operate it, and recover it. Infrastructure, monitoring, analytics, recovery, and support are part of the product. Without them, the company may release working features and still be unprepared for real customers.

Launch opens a new stage of the SaaS product development process, one with a different type of evidence.
Before launch, product decisions rely on research, interviews, prototypes, technical assumptions, and limited user testing. After launch, the team can observe how real customers discover, activate, use, and leave the product.
This stage uses that evidence to improve customer value and business performance. The team refines the roadmap, scales proven workflows, and manages the technical cost of continuous change.
Analytics show what users do. Customer feedback explains why. The team needs both to make reliable product decisions.
The events set up before launch now show how users move through the platform, from account creation and onboarding to repeat use of the core workflow, subscription conversion, and churn.
Feedback comes from interviews, support conversations, surveys, reviews, cancellation reasons, and sales calls. Each source has limits: support tickets overrepresent users who ran into a problem, and sales requests often come from prospects who haven’t used the product yet. The data and the conversations work best together. A drop in onboarding completion becomes far more useful when interviews reveal that users don’t understand a required setup step.
Keep in mind that customers are good at describing their problems and less reliable at designing the solution. Before adding a requested feature to the roadmap, the team should find the reason behind the request.
Each proposed feature should be evaluated against clear criteria:
The team should also separate urgent issues from strategic opportunities. A critical defect, an onboarding problem, and a request from one large prospect each call for a different decision.
The roadmap should stay connected to product goals. If retention is weak, acquisition features may increase sign-ups without fixing the reason users leave. If activation is the main constraint, the team should first improve onboarding and time to value.
The scaling roadmap should follow real product demand, using production data alongside the forecasts made before launch.
That data shows where pressure is building: performance bottlenecks, expensive infrastructure components, large tenants affecting others, slow database operations, integration limits, storage growth, background job delays, and support capacity.
Scaling can involve infrastructure changes, database optimization, caching, asynchronous processing, service separation, or stronger monitoring. It may also require changes to support, billing, customer onboarding, and release management.
Technical scaling and business scaling should stay connected. An enterprise plan may require audit logs, advanced roles, data residency, service-level commitments, and administrative controls. Each of these affects architecture and operations along with pricing.
The roadmap should define which signals trigger each investment. This prevents premature complexity and gives the team time to respond before growth affects customers.
Technical debt includes shortcuts, outdated dependencies, weak test coverage, duplicated logic, missing documentation, and architecture decisions that no longer fit the product.
Some technical debt is a conscious trade-off. An MVP team may choose a simpler implementation to validate demand faster. The problem begins when that trade-off is hidden or never reviewed. Each debt item should be recorded with the affected component, the original reason for the decision, its current impact, the risk of delaying the fix, the estimated effort, and the recommended timing.
Post-launch growth is a continuous balance between customer value, business priorities, platform reliability, and development speed. A mature SaaS development process uses real evidence to manage that balance.
One of our projects, HeadsUp Health, shows what long-term improvement looks like on a live product. Since 2019, our dedicated team has worked alongside the client’s in-house developers to modernize the platform for performance and UX. The work included rewriting the frontend from jQuery and Rails to React, rebuilding the mobile apps natively in Swift and Kotlin, and setting up a dedicated testing team to keep releases stable as the product grew.
The most costly mistakes usually come from decisions made without enough evidence. Use the phase sections above for the full prevention steps; this list is a quick review before committing to the next stage.
| Mistake | Practical check |
| Starting without discovery | Can the team name the buyer, problem, and release goal? |
| Overloading the MVP | Does every first-release feature support the core journey or a release requirement? |
| Postponing architecture | Are tenant isolation, permissions, data ownership, and integrations defined? |
| Choosing a stack too early | Do requirements justify each material technology choice? |
| Allowing the backlog to drift | Are priorities, dependencies, and acceptance criteria recorded? |
| Designing only ideal screens | Do flows include roles, errors, loading, and empty states? |
| Testing only at the end | Are critical workflows checked throughout implementation? |
| Launching by calendar date | Have owners approved quality, operations, analytics, and recovery? |
| Measuring vanity metrics | Can the team connect analytics to activation, retention, and product decisions? |
| Ignoring maintenance | Is there capacity for security, reliability, and technical debt after launch? |
At Clockwise Software, we offer SaaS development services and have worked on more than 25 SaaS products across different industries and stages of growth. Some clients came with an early product idea. Others needed to replace legacy software, extend an existing platform, or scale a product already used by paying customers.
The delivery process changes with the product, but the principles remain consistent. Each project begins by defining the business objective, product scope, decision owners, delivery risks, and measurable outcomes.

Our team always starts by clarifying the problem, target users, business model, and current evidence. Business analysts, designers, and technical experts work with a client to identify assumptions and define what the first release must prove.
Depending on what you already have, a discovery process can look different: we always take into account what a client already has to avoid repeating the work that’s already done. The output is a practical foundation for delivery: product vision, scope, roadmap, tech approach, risk register, and estimate.
Our architects evaluate multitenancy, security, data flows, integrations, infrastructure, expected usage, and future growth before development begins.
The team does not apply the same architecture to every SaaS product. A focused MVP, an enterprise platform, and a regulated healthcare system have different requirements. Architecture decisions are based on the product stage, risk level, budget, and expected operating model.
Plus, we document all technical decisions and explain them to the client before development starts. This gives the client visibility into the selected approach and reduces dependence on individual developers.
The approved scope is converted into a prioritized backlog with clear acceptance criteria. Development proceeds in 2-week iterations, with working functionality reviewed throughout the project.
Regular demos give stakeholders direct visibility into progress. They can see how the product behaves, clarify requirements, and provide feedback before the team moves too far in the wrong direction.
We also pay attention to changes: they are never added without the client’s approval or hidden inside active work. When a new request comes up, the team evaluates its impact on the timeline, budget, and existing priorities. The client can then make an informed decision.
We monitor delivery performance using the Cost Performance Index and Schedule Performance Index. CPI compares completed work with the cost spent to produce it. SPI compares completed work with the planned schedule. These indicators help identify budget or delivery variance before it becomes a major problem.
Metrics are reviewed together with actual project conditions. A number alone does not explain why performance changed. Scope changes, dependencies, delayed approvals, technical risks, and team availability must also be considered. The purpose is to give the client an early warning and a clear explanation.
At Clockwise Software, our specialists use AI-assisted development where it can improve speed and consistency. Depending on the project, AI tools may support research, requirements analysis, boilerplate code, test generation, documentation, and incident investigation.
Engineers remain responsible for architecture, business logic, security-sensitive code, data access, infrastructure, and production decisions. Generated outputs are not accepted without going through a 5-stage validation pipeline:
This approach helps us accelerate routine tasks without transferring technical responsibility to an AI system. At the same time, a client can get a product faster, without sacrificing its quality.
Risks are reviewed during every stage of SaaS development. For each risk, our team assigns an owner, estimates expected impact, creates a mitigation plan, and sets a review point.
Typical risks appear around unclear requirements, third-party dependencies, data migration, security constraints, integration limits, and delayed stakeholder decisions. All of them are documented in a risk register. The team keeps it up to date, reviewing the plans as new evidence appears.
This process doesn’t instantly make SaaS product development free from uncertainty, but it makes uncertainty visible and manageable. This makes development much more predictable — it’s one of the reasons how we manage to deliver with CPI/SPI variance less than 10%.
A reliable SaaS product begins with more than an idea and a development team. It needs a validated problem, controlled scope, suitable architecture, measurable release criteria, and a plan for learning after launch.
Our team at Clockwise Software can help you define these decisions before they become expensive development constraints. Our team supports the complete SaaS product development process, including discovery, UX/UI design, architecture, MVP development, testing, launch, and post-release scaling.
Whether you are planning a new SaaS platform, replacing legacy software, or improving an existing product, the first step is to clarify the current stage, risks, and most useful next deliverable.
